Florida Homeowners: Finish Your Solar Installation in 6–12 Weeks

Residential solar installation runs through five owned phases: design, permitting, procurement, physical installation, and utility approval. The hands-on work of mounting panels and wiring usually takes one to three days, but the full process from signed contract to Permission to Operate often stretches six to twelve weeks. Your first move: gather 12 months of utility bills and clear roof photos so your installer can size the system correctly from day one.
TL;DR:
Accurate shading analysis should show less than 10 to 15 percent loss for south-facing roofs or design adjustments may be needed.
Permitting and utility approval typically take several weeks each, so filing those applications in parallel can significantly reduce project delays.
Equipment ordering should wait until permit approval to avoid mismatches due to design changes or utility requirements, with lead times varying by manufacturer.
Installation usually completes within one to three days, but unexpected panel or electrical panel upgrades can extend the schedule.
Final approval depends on passing inspection and utility Permission to Operate, which can take one to four weeks after system readiness.
Table of Contents
What Happens During Site Assessment and Design Verification?
Before anyone touches your roof, your installer has to prove the system will actually work where you live. This is design verification, and it’s where sloppy installers cut corners that show up later as failed inspections or underperforming panels.
Shading analysis comes first. Installers use tools like Aurora Solar or Helioscope to model sun exposure across every hour of the year, accounting for nearby trees, chimneys, and neighboring rooflines. The output you should expect is an annual production estimate paired with a shading loss percentage. A loss figure above 10 to 15% on a south-facing roof usually means the design needs adjusting, whether that’s panel relocation or trimming a problem tree.
Structural checks come next. Your installer should verify roof age, decking condition, and rafter spacing before specifying mounting hardware. If your roof is older or has unusual framing, expect a request for a structural letter from a licensed engineer. Skipping this step is one of the fastest ways to end up with a rejected permit.
Electrical service review rounds out the assessment. The installer checks your main panel’s amperage capacity and available breaker space, and evaluates your setup against NEC 705.12 interconnection rules, which govern how a solar system safely ties into your existing electrical service.
By the end of this phase, you should receive:
A site plan showing panel placement and roof orientation
A detailed panel layout diagram
A single-line diagram (SLD) showing how the system connects electrically
Equipment datasheets for panels, inverters, and racking
If any of these documents are missing before you sign a contract, ask for them. A thorough design verification at this stage prevents the kind of on-site surprises that cause rework weeks later.
How Do Permitting and Utility Interconnection Work?

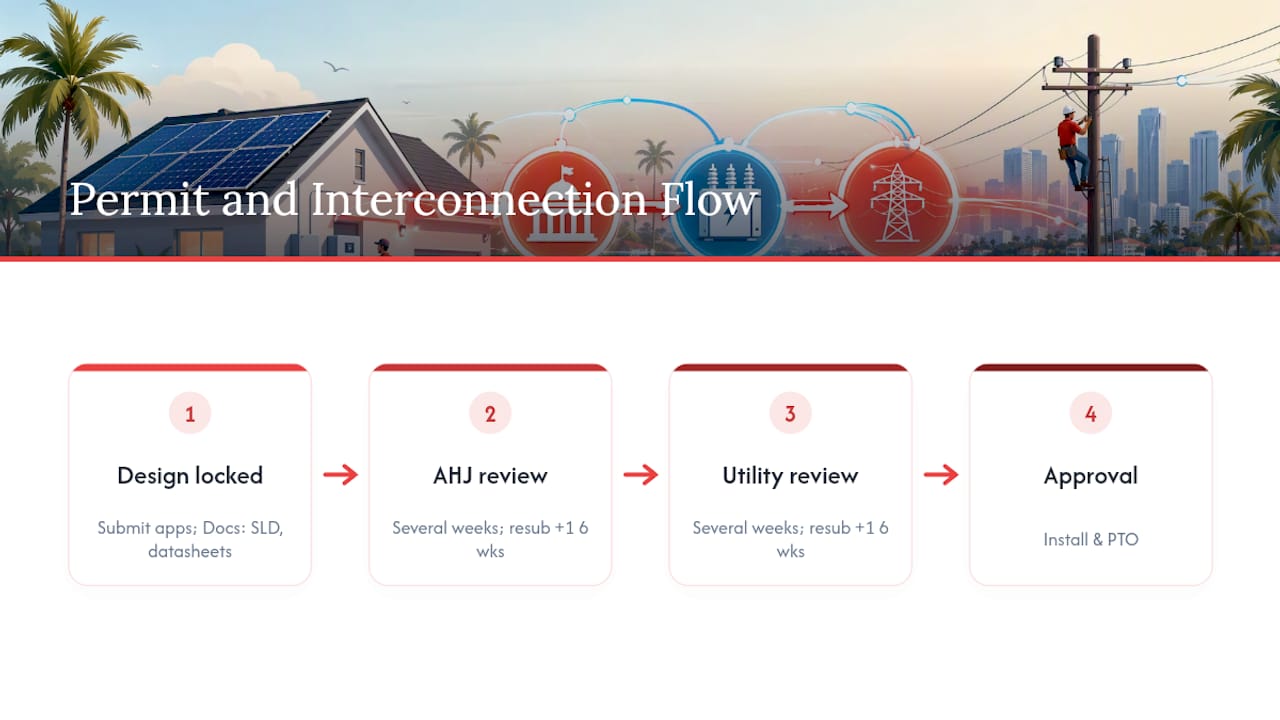

Once your design is locked, your installer submits two separate applications that run on different clocks: a building permit through your local Authority Having Jurisdiction (AHJ), and an interconnection application through your utility.
The permit package typically includes the signed single-line diagram, equipment specification sheets, a fire department access plan, rapid-shutdown compliance details, and, when required, that structural letter. Your installer files this, not you, but you should confirm the paperwork is complete before it goes out the door. Missing or mismatched documentation is the single most common cause of resubmittals, and every resubmittal adds one to three weeks to your timeline.
Permit review and utility interconnection application timing vary widely by location and utility, typically taking several weeks each. Smart installers file these applications to run in parallel when possible to reduce total project duration.

Pro Tip: Ask your installer for a copy of the filed single-line diagram and equipment datasheets before submission. A five-minute review on your end can catch a typo or wrong model number that would otherwise trigger a rejection weeks later.
Before anything gets filed, confirm three things: the SLD carries the correct signature, the datasheets match the actual equipment being installed (not a substitute), and any required structural letter is attached. Homeowners in Florida can review local permit requirements to understand what their specific AHJ expects.
Why Does Equipment Ordering Timing Matter?
Solar equipment doesn’t sit on a shelf waiting for you. Inverters, and especially specific battery models, can carry lead times of several weeks depending on manufacturer demand. That’s why most reputable installers wait until permit approval before placing final equipment orders.
Ordering too early creates a real risk: if your AHJ or utility requires a design change, you’re stuck with equipment that no longer matches the approved plan. Ordering too late stretches your calendar unnecessarily. The sweet spot is placing orders the moment permit approval comes through, timed against the manufacturer’s current lead time so the crew isn’t standing around waiting on a truck.
A few things worth confirming with your installer:
Whether any specified equipment appears on your utility’s approved-equipment list, particularly for battery storage
The confirmed delivery window and who’s responsible for site access on delivery day
Whether staging equipment (racking, conduit) arrives separately from panels and inverters
Resubmittals and design changes add administrative hours and can delay your production start significantly.
What Actually Happens on Installation Day?
This is the part homeowners picture when they think about solar, and it moves faster than most expect. A typical residential job takes one to three days on-site, occasionally longer for larger systems or panel upgrades.
Crew arrival and safety setup. The crew stages equipment, sets up fall protection, and reviews the job with a walkthrough against the approved plans.
Racking installation. Mounts get attached to rafters through the roof decking, with flashing installed at each penetration point to keep water out. Correct torque on every attachment point matters here. Under-torqued hardware is a leading cause of racking failure in high wind, and Florida’s storm exposure makes this step non-negotiable.
Panel mounting and wiring. Panels attach to the racking, then get wired together in strings or connected individually through module-level power electronics (MLPE) like microinverters or power optimizers, depending on your system design.
Inverter mounting and AC interconnection. The inverter goes up, usually on an exterior wall near the main panel, and gets tied into your home’s electrical system.
Main panel work. This is where schedules sometimes slip. If your electrical panel needs a new breaker or, less commonly, a full panel upgrade to accommodate the solar circuit, that work adds time and may require its own separate inspection.
Pro Tip: Walk your roof with the crew lead before they pack up for the day if the job spans multiple days. Ask them to point out every flashing and penetration point. It takes five minutes and gives you a clear reference if a leak ever surfaces.
A common on-site surprise is discovering the electrical panel needs an upgrade not visible during the initial assessment, which can extend the schedule.
What Do Inspection and Utility Interconnection Involve?
Your system can’t legally produce power until it clears two separate approval gates: a local electrical inspection and utility Permission to Operate (PTO).
The inspector checks specific items, and knowing them helps you spot problems before they become delays:
Correct racking attachment and flashing at every roof penetration
Proper wire labeling and conduit sizing throughout the run
A functioning rapid-shutdown system, as required by code
Grounding and bonding at every connection point
Once you pass inspection, the utility takes over. This stage includes final equipment approval, a meter exchange or reprogram to handle two-way energy flow, and assignment of your net metering rate structure. This step alone can take one to four weeks depending on your utility’s current workload.
One detail catches homeowners off guard every year: you cannot legally turn the system on and use it for savings until PTO is granted, even though it sits fully wired and functional on your roof. Energizing early can void warranties and, depending on your utility agreement, expose you to penalties. Confirm PTO status directly with your installer or utility, in writing, before flipping anything on.
Installers who file the interconnection application in parallel with the permit, rather than sequentially, routinely cut weeks off this final stretch. That overlap is one of the biggest levers in the entire timeline.
What Testing and Documentation Happen at Commissioning?
Once PTO clears, your installer runs a set of commissioning tests before calling the job complete. This includes an IV curve test to confirm each string is producing expected voltage and current, an insulation resistance test to check for wiring faults, and a rapid-shutdown verification to confirm the safety system actually cuts power on command. The inverter also gets locked to your system’s maximum power point tracking (MPPT) settings.
Monitoring activation happens here too. In your first week, verify that your monitoring app or portal shows live production data, and if your system includes per-panel monitoring, check that each panel reports individually rather than showing a single aggregated number.
At handover, you should receive:
As-built drawings reflecting the actual installed system
Warranty registration confirmations for panels, inverter, and racking
Signed inspection and PTO documentation
A basic operating guide for your monitoring platform
Keep all of it in one folder, physical or digital. You’ll want it for warranty claims, resale, and any future system changes.
What Maintenance and Support Should You Expect After Install?
Solar systems are low-maintenance, but not zero-maintenance. A quick visual check every few months, watching for debris, cracked panels, or loose mounting hardware, catches most issues early. Check your monitoring app monthly to confirm production tracks with expectations.
If production drops unexpectedly, gather your monitoring data covering the affected period before calling anyone. That data tells your installer or warranty provider exactly what happened and speeds up the response. Seasonal dips are normal: shorter winter days and a lower sun angle reduce output naturally, and that’s different from a fault. A sudden drop unrelated to season or weather is the real red flag.
Keep your permit files, PTO letter, and warranty documents together long-term. For routine upkeep questions, panel cleaning guidance covers what actually needs attention versus what doesn’t.
How Does Myfloridasolar Manage This Process for Homeowners?
Myfloridasolar handles residential PV installations, solar pool heating, and solar hot water systems across Florida, and every one of those installs runs through the same phases outlined above. The difference for homeowners who work with Myfloridasolar is that permit filing, AHJ coordination, and utility interconnection paperwork are handled by a team that already knows Florida’s local jurisdictions.
That local knowledge matters. An AHJ in one Florida county may want documentation formatted differently than one two counties over, and knowing that ahead of time avoids the resubmittal cycle described earlier. Homeowners working with Myfloridasolar have a single point of contact for scheduling inspections and tracking utility approval, rather than chasing down status updates themselves. For a broader look at what going solar involves specifically in Florida, this local guide covers state-specific considerations worth knowing before you sign anything.
Three Habits That Prevent Most Installation Delays
Most delays trace back to the same handful of mistakes, and they’re avoidable with a little upfront discipline.
Assign one person, on your side, to own the permit and utility paperwork trail. Don’t let follow-up calls with the AHJ or utility fall through the cracks because “someone else was handling it.” Second, if your design includes battery storage or unusual equipment, confirm it appears on your utility’s approved-equipment list before your installer orders it. That single phone call can save weeks. Third, hand over complete utility bills and clear roof photos at the very start. Incomplete data at the design stage is the root cause of a surprising number of resizing headaches later. None of these three things cost money. They cost about twenty minutes of attention, and they are the difference between a six-week project and a twelve-week one.
— Ronnie
Ready to Start Your Free Solar Estimate?
Myfloridasolar handles the entire process described here, from shading analysis and permit filing through inspection scheduling and utility sign-off, so you’re not managing five different vendors on five different timelines.

If you’re ready to see what a system would look like on your own roof, request a free solar estimate and Myfloridasolar will walk your property, review your electrical service, and give you a real production estimate along with a permit-to-PTO timeline specific to your home. That’s the next concrete step, and it costs you nothing to find out.
